Temporary Browning Road Bridge

Back To New Jersey Metal Truss Bridges Page

NBI Information

Location

State: New Jersey

County: Camden County

Feature Carried: Browning Road (CO-659)

Feature Crossed: I-295

Latitude, Longitude: 39.8717,-75.1017

Toll: On free road

Maintenance Responsibility: State Highway Agency

Structure Open, Posted, or Closed to Traffic: Open, temporary structure in place to carry legal loads while original structure is closed and awaiting replacement or rehabilitation

History

Year Built: 2021

Historical Significance: Historical significance is not determinable at this time.

Year Reconstructed: None

Date Demolished: August 19, 2025

Picture Date: September 2, 2023 and August 19, 2025

Geometry

Lanes on Structure: 2

Lanes under Structure: 13

Skew: 38 degrees

Number of Main Spans: 2

Main Structure Type: Truss - Thru

Main Structure Material: Steel

Number of Approach Spans: None

Approach Structure Type: None

Approach Structure Material: None

Condition

Inspection Date: April 2022

Deck Condition: Satisfactory

Superstructure Condition: Poor

Substructure Condition: Satisfactory

Channel Condition: Not Applicable

Culvert: Not Applicable

NBI Year: 2024

Bridge Information

The Temporary Browning Road Bridge is part of the ongoing Direct Connection Project. This project is a $900 million project designed to improve safety and reduce traffic congestion at the intersection of I-295 with I-76 and Route 42 by providing a new direct passage for I-295 through traffic.

The temporary bridge is needed to that the existing Browning Road bridge can be replaced without causing significant impact to the traveling public. The completion of the new bridge will allow for the installation of the I-295 roadway which will be placed overhead.

The temporary bridge is a modular truss-style bridge that was developed by Acrow Corporation. The Acrow bridges are modern versions of the Baily Bridges that were used in WWII. This bridge carries 2 travel lanes (one in each direction), as well as a pedestrian sidewalk and numerous utilities. It is a two-span structure with span lengths of 240 ft and 210 ft, and a roadway width of 24 ft.

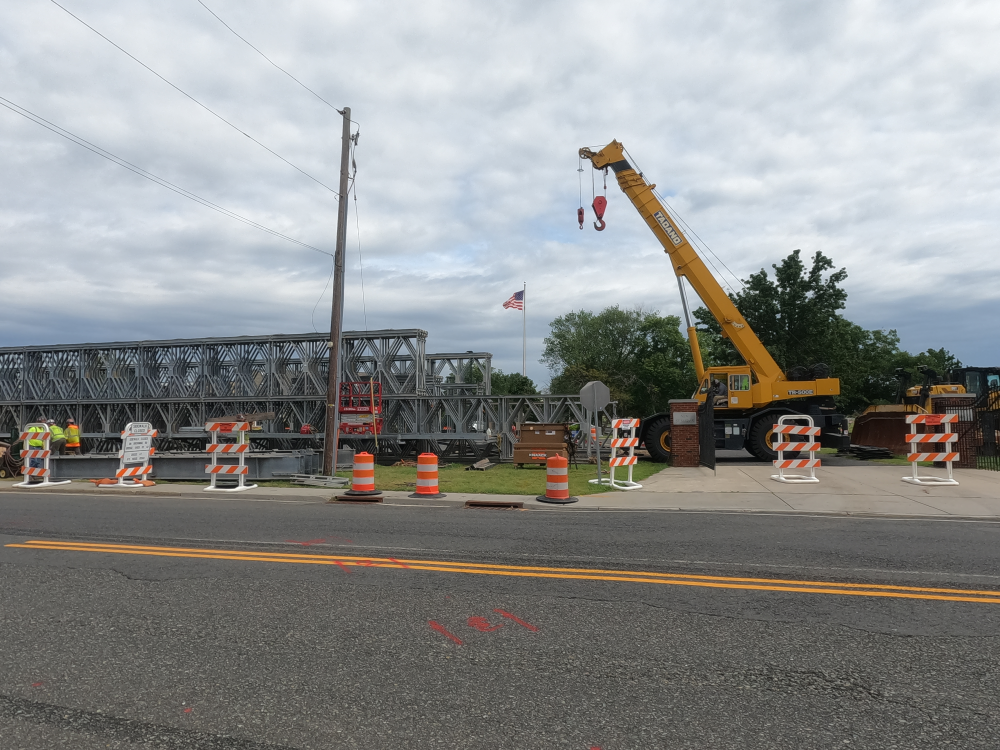

The installation of the bridges is fascinating because the bridge is pushed (or launched) into place, not lifted by canes like a conventional bridge. The bridge was assembled in 3 main sections. As each section is completed, it was pushed or launched into place. The first push resulted in an approximately 100-foot section of the temporary bridge beyond the east abutment. The second push extended the temporary bridge to the center pier and partial beyond it. The third push extended the bridge all the way to the west abutment. This launch occurred in early August of 2021.

After the bridge was launched, there was still several weeks of work that needed before traffic could be shifted. That work included completing the approaches, installing deck panels, securing utilities, and completing the pedestrian walkway. The bridge opened in the fall of 2021 and was anticipated to be in use for two years.

The new Browning Road Bridge opened to traffic on June 13, 2025, and the temporary bridge was closed. It was removed in August of 2025, and was in use for two years longer than originally anticipated.
